Skip to content
Shiny.NET

Gantt

GanttView is a project timeline: a task grid on the left, a scrolling time axis on the right, and bars you can drag. It covers the things that make a Gantt a Gantt rather than a bar chart of dates — hierarchy with rolled-up summaries, typed dependency arrows with lag, working-time calendars, constraints, baselines, deadlines, and a critical path.

  • NuGet downloads for Shiny.Maui.Controls
  • NuGet downloads for Shiny.Blazor.Controls
  • NuGet downloads for Shiny.Controls.Gantt.Shared
Frameworks
.NET MAUI
Blazor

MAUI

Critical path Plain plan

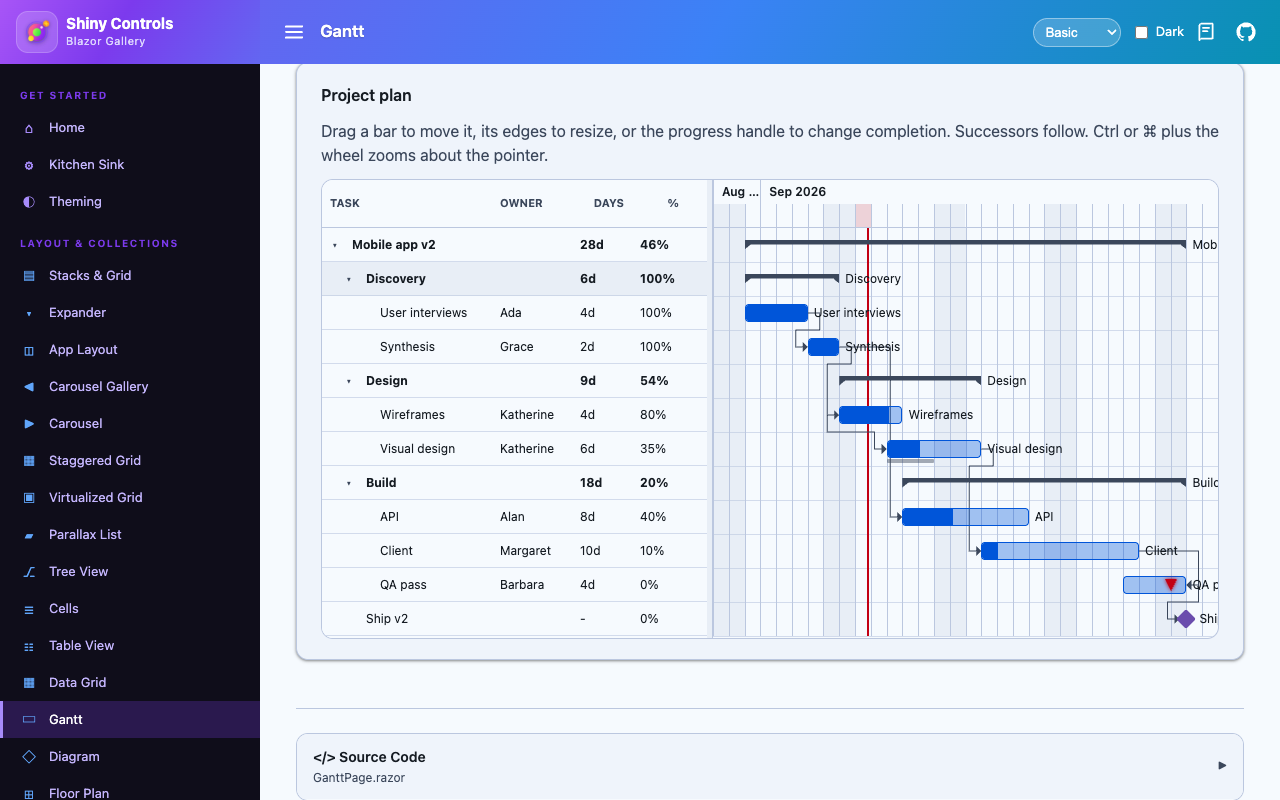

A Gantt plan with the critical path highlighted on .NET MAUI The same plan with the critical path off on .NET MAUI

Blazor

Critical path Plain plan
A Gantt plan with the critical path highlighted on Blazor The same plan with the critical path off on Blazor
Baselines Week scale

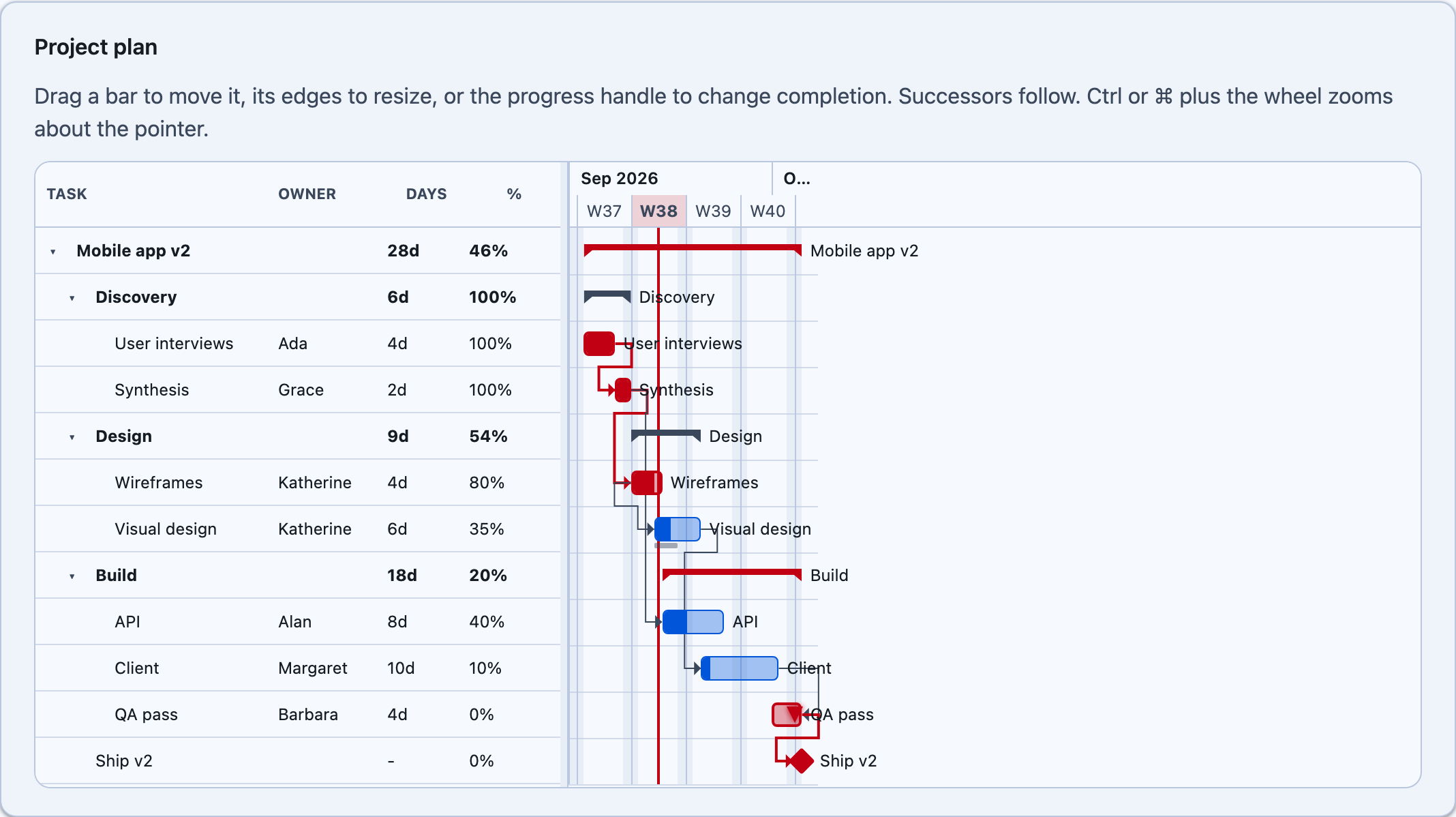

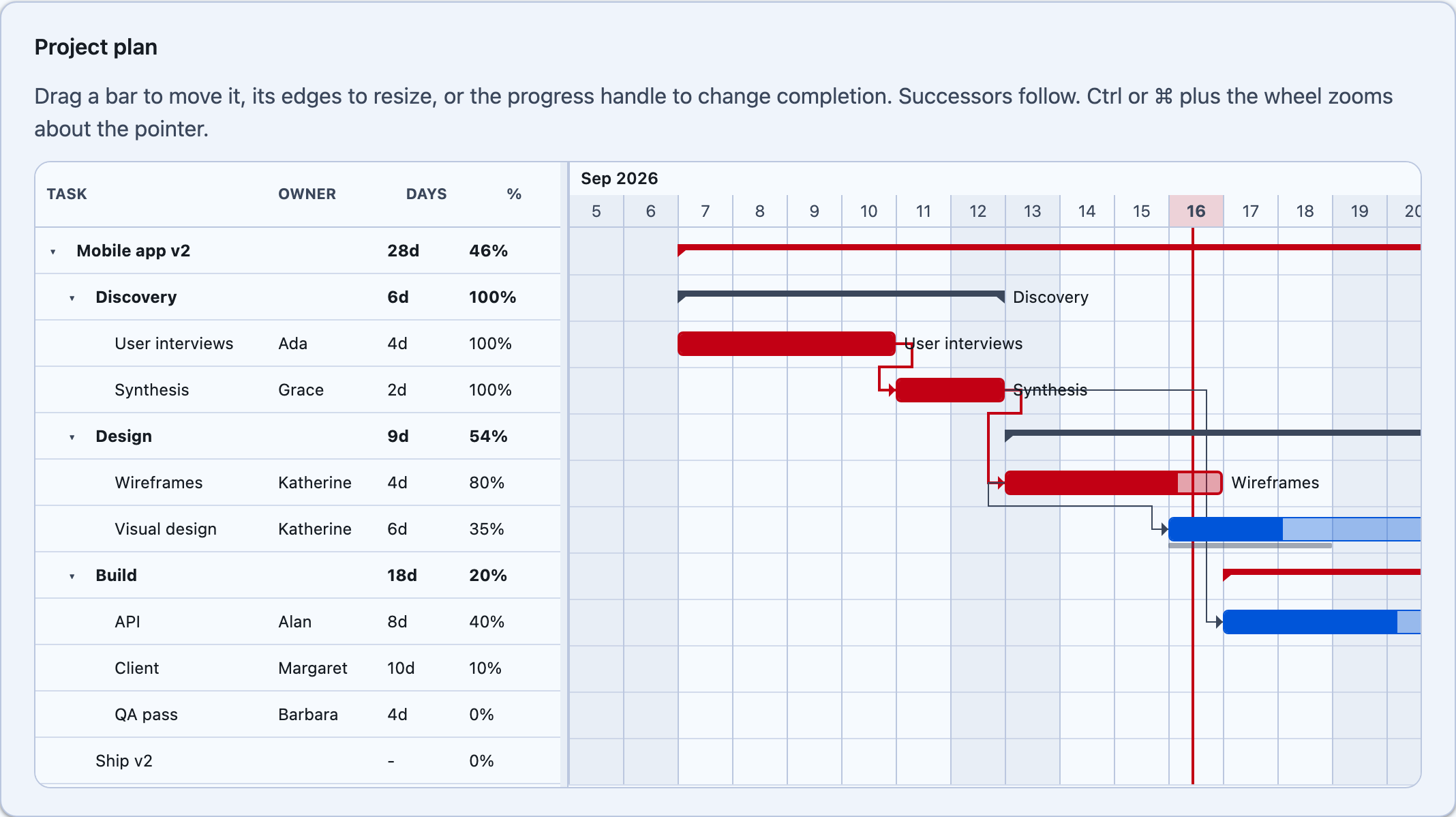

Baseline bars drawn under the planned bars on Blazor The whole plan zoomed out to a week-per-column scale on Blazor

A Gantt is mostly arithmetic. Working out that a three-working-day task dragged onto a Friday now finishes on Wednesday, that pushing it drags four successors with it, that one of those has a must-start-on constraint holding it, and that the whole chain is now on the critical path — none of that wants to know whether it is drawing into a MAUI layout or a CSS grid.

So it doesn’t. Shiny.Controls.Gantt.Shared owns the model, the calendars, the scheduler, the critical path and the time-to-pixel geometry — down to the exact rectangle every bar occupies and the polyline every arrow follows. Both controls are thin: they turn gestures into a GanttSchedulePlan and paint what the engine tells them to.

A plan that schedules differently on the two hosts is a bug neither host’s own tests would ever notice, so the arrangement removes the possibility rather than testing for it. The package is dependency-free, trimmable and AOT-clean, and is perfectly usable on its own — for a scheduling API, a background job, or a test — with no UI at all.

Feature Description
Hierarchy expressed as a flat list with ParentId, as nested Children, or both at once
Summary rollups parent dates and progress derived from children, progress weighted by duration
Milestones zero-duration diamonds
Dependencies all four types (finish-to-start, start-to-start, finish-to-finish, start-to-finish) with positive or negative lag, drawn as routed elbow arrows
Working calendars working days, shifts within a day, holidays and per-date exceptions
Constraints must-start-on, start-no-earlier-than, finish-no-later-than and the rest
Baselines & deadlines the original plan drawn under the live bar; a marker for the date it must not pass
Drag to schedule move a bar, resize either edge, drag the progress handle; successors follow
Draw links drag between connector dots to create a dependency
Critical path total slack per task, with the zero-slack chain highlighted
Task pane configurable columns, tree indent and expanders, draggable splitter
Zoom minute through year, anchored pinch (MAUI) and ctrl/⌘-wheel (Blazor), zoom-to-fit
Undo every edit is a revertible plan
Theming every colour follows the theme tokens on both hosts
using Shiny.Controls.Gantt;
var tasks = new ObservableCollection<GanttTask>
{
new() { Id = "design", Name = "Design", Start = start, End = start.AddDays(5) },
new() { Id = "wire", Name = "Wireframes", ParentId = "design",
Start = start, End = start.AddDays(3), Progress = 0.8, ResourceId = "Ada" },
new() { Id = "ship", Name = "Ship", Kind = GanttTaskKind.Milestone, Start = start.AddDays(20) }
};
var links = new ObservableCollection<GanttDependency> { new("wire", "ship") };

MAUI

xmlns:shiny="http://shiny.net/maui/controls"
xmlns:gantt="clr-namespace:Shiny.Controls.Gantt;assembly=Shiny.Controls.Gantt.Shared"
<shiny:GanttView Tasks="{Binding Tasks}"
Dependencies="{Binding Dependencies}"
Calendar="{x:Static gantt:GanttCalendar.StandardDays}"
ShowCriticalPath="True"
TimeScale="Day"
TaskChanged="OnTaskChanged">
<shiny:GanttView.Columns>
<shiny:GanttColumn Header="Task" Field="Name" Width="160" ShowHierarchy="True" />
<shiny:GanttColumn Header="Owner" Field="Resource" Width="90" />
</shiny:GanttView.Columns>
</shiny:GanttView>

Blazor

@using Shiny.Blazor.Controls.Gantt
@using Shiny.Controls.Gantt
<div style="height:460px">
<GanttView Tasks="tasks"
Dependencies="links"
Calendar="GanttCalendar.StandardDays"
ShowCriticalPath="true"
TimeScale="GanttTimeScale.Day"
Columns="columns"
OnTaskChanged="OnTaskChanged" />
</div>

Every gesture builds a GanttSchedulePlan before anything moves — the edited task first, then every task the auto-scheduler would drag along. That is what lets you veto an edit with the whole consequence in front of you:

void OnTaskChanging(GanttTaskChangingArgs e)
{
if (e.Plan.Changes.Any(c => c.NewEnd > this.freezeDate))
e.Cancel = true;
}

…and it gives you undo for nothing, because a plan reverts itself, cascade included:

readonly Stack<GanttSchedulePlan> undo = new();
void OnTaskChanged(GanttTaskChangedArgs e) => this.undo.Push(e.Plan);
void Undo() => this.undo.Pop().Revert();

CascadeMode decides how far an edit ripples: PushOnly (the default — successors move later, never earlier), Strict (re-derived in both directions), or None (nothing else moves; broken links are reported instead).

Real project data routinely contains a dangling dependency, a duplicate id, or a task that misses its deadline. A control that threw on one would be unusable against it; one that silently dropped it would be worse.

So a plan that fails validation still renders, and GanttModel.Issues says what is wrong — read it from PlanBuilt (MAUI) or OnPlanBuilt (Blazor). Cycles are the one case that genuinely blocks an edit: a cyclic graph has no schedule to compute, so drawing a link that would close one is refused.
